Approvals and appeals
Conditional-use approvals followed by denial of county appeals.
Public schedule
Dates below distinguish recorded county events from applicant proposals. Later source updates were reviewed September 7, 2026; a construction start remains unverified.
Conditional-use approvals followed by denial of county appeals.
Appeal ordinance adopted as amended. Separate from project approvals.
Nonbinding proposal; definitive agreements, financing and delivery remain conditional.
A construction start or subsequent project approval supported by a dated record.
County materials say land-use applications for the data center and the related Wells Draw Energy and reWater permits were submitted and deemed complete.

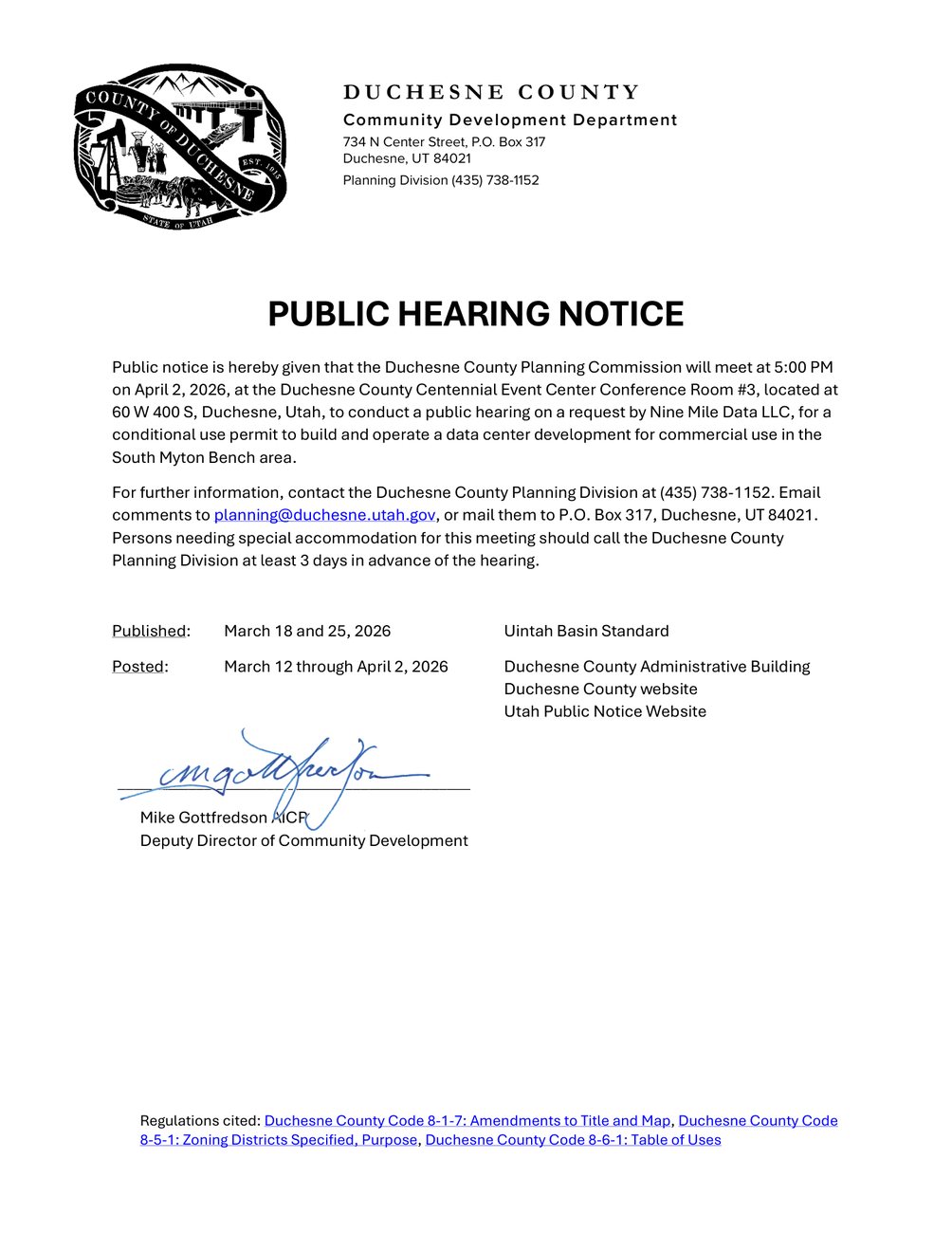

Public hearing notices for the Nine Mile Data conditional-use permit were published in the Uintah Basin Standard on March 18 and 25, ahead of the April 2 Planning Commission hearing.

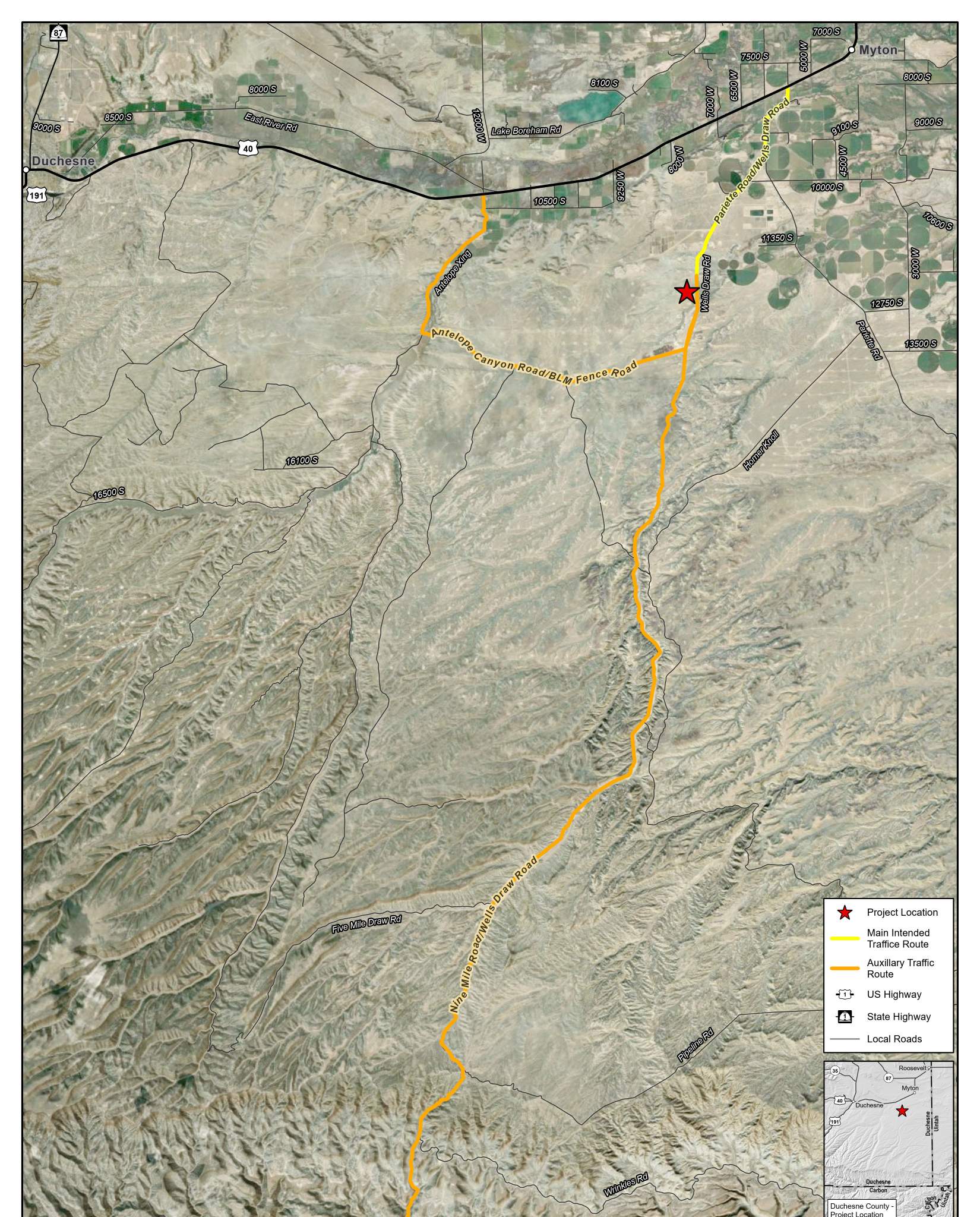

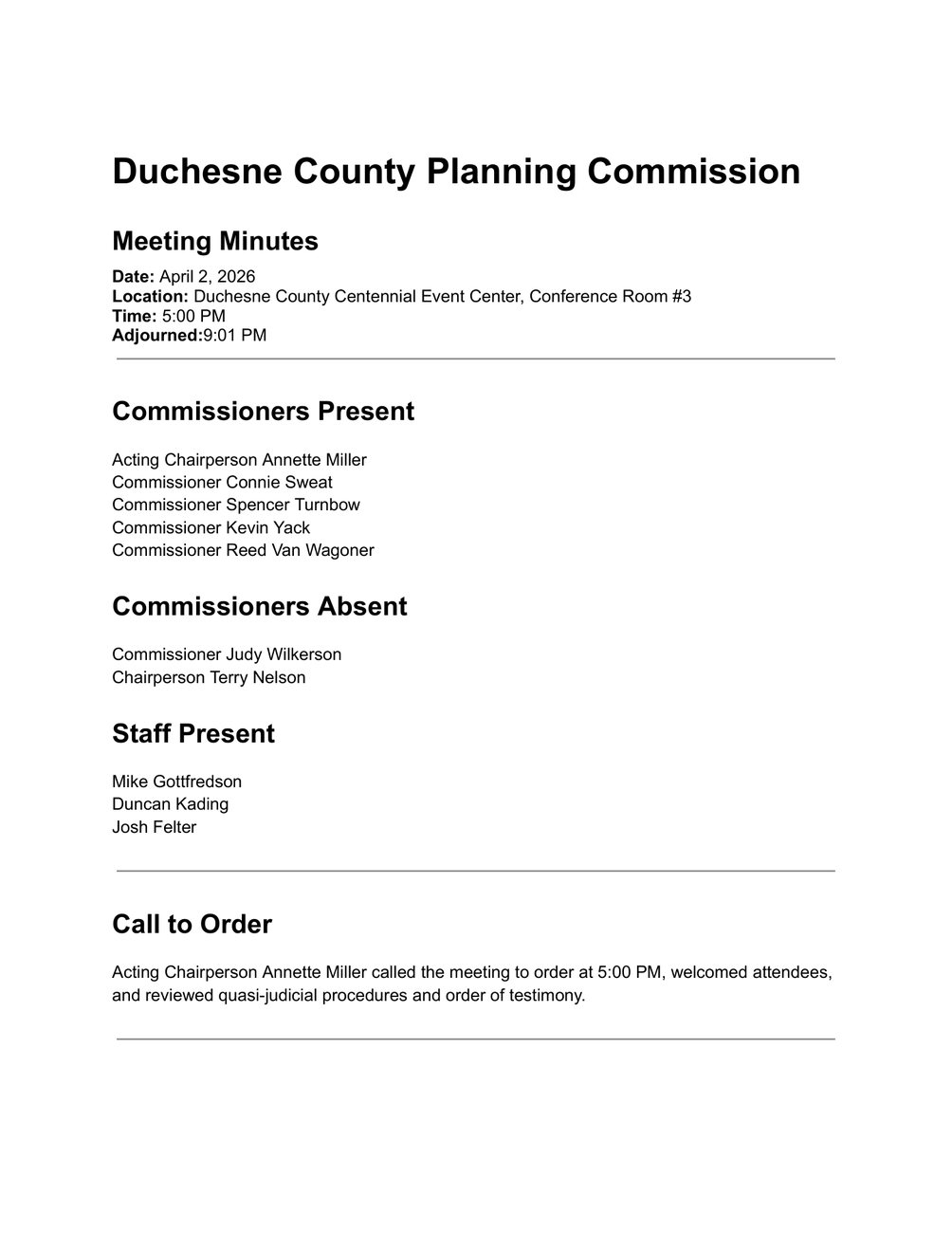

At its April 2 hearing the Duchesne County Planning Commission considered and granted conditional-use permits for the data center and the related solar and natural-gas plants (Wells Draw Energy), alongside the separate reWater produced-water proposal.
Resident appeals of the approvals were heard by the County Commission and denied, one for lack of standing. The county permits stand; Basin Now reported the denials on April 28.
These remain forecasts; no verified construction start is established.
The filing contains different applicant schedules: its executive summary targets 2026, while narrative section 2.2 says 2027. Neither date establishes a verified construction start.
The narrative targets operation before 2030, around 2029; the filings show some timing inconsistencies.
The narrative describes a facility life of at least 50 years from the start of operation.
Approved minutes record a unanimous vote approving Ordinance 26-432 as amended. This countywide procedural action does not by itself change the April project decisions. The final amended text and effective date remain to be reviewed.
Approved minutes, page 2 · posted August 31In an August 11 company announcement, Senmiao described a nonbinding proposal for a staged $5 million development investment in Energence Utah. It identified Energence Power as sponsor/managing member and Elio Energy Development as a development-services provider. Definitive agreements and closing conditions remain outstanding in the reviewed evidence; financing completion and construction have not been verified.
Source: August 11 issuer announcement
